Forest Oak Middle School

This Project is Under Construction

Key Information

Scope of Work:
This project includes a combination of new construction, building renovations, and site improvements.

Program Initiatives Addressed:

  • Building Addition(s)
  • Classrooms and Science Labs
  • Media Center
  • Cafeteria/Cafetorium
  • Collaboration Space(s)
  • Interior Corridors
  • Secured Front-Entry Vestibule
  • Security and Life Safety Upgrades
  • MEP (Building Utilities)
  • Accessibility and Site Improvements
  • Furniture, Fixtures and Equipment
  • Technology and Digital Upgrades
  • Removal of Portable Building(s)
Design Process
Construction Process
3221 Pecos St, Fort Worth, TX 76119, USA
Budget
$64,135,847
New Construction
73,059 SF
Renovations
90,801 SF
Construction Start
January 22, 2025
Anticipated Opening
June 2027
Anticipated Construction End
Q3 2027

Project Team

Cameron Whitaker
Owner’s Representative
Pete Valdez
Senior Construction Manager
Contractor
Sedalco | Post L JV
Perkins and Will logo.
Architect
Perkins&Will

Project Updates

Subscribe to emails with updates for this project. You’ll receive a verification email after your first project sign-up.

05/20/2026
Forest Oak Middle School:
Phase 5 Summary

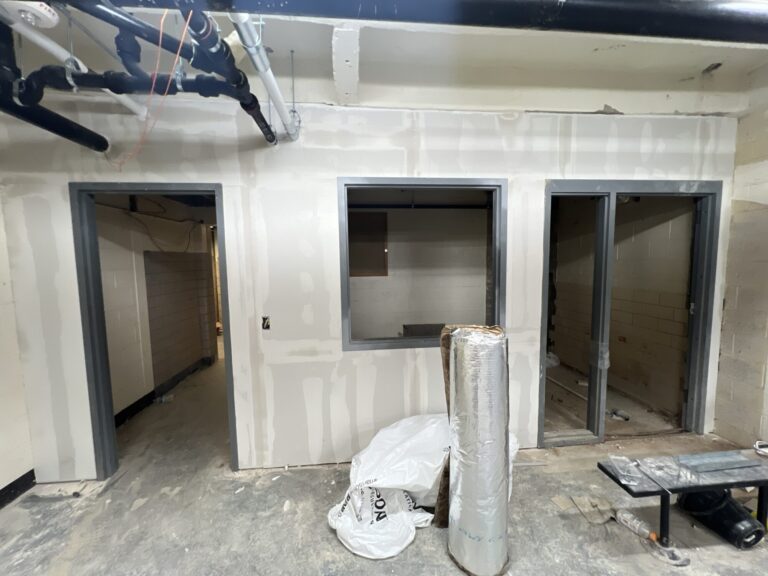

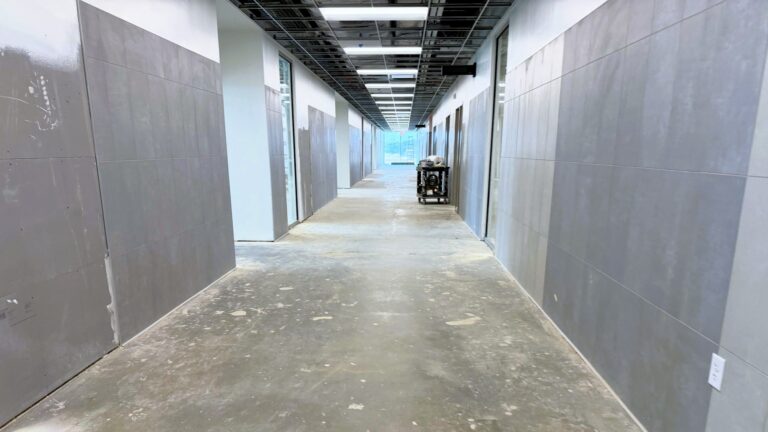

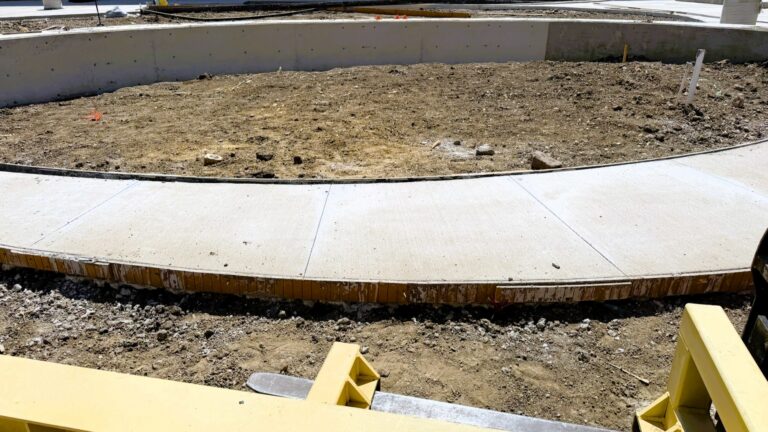

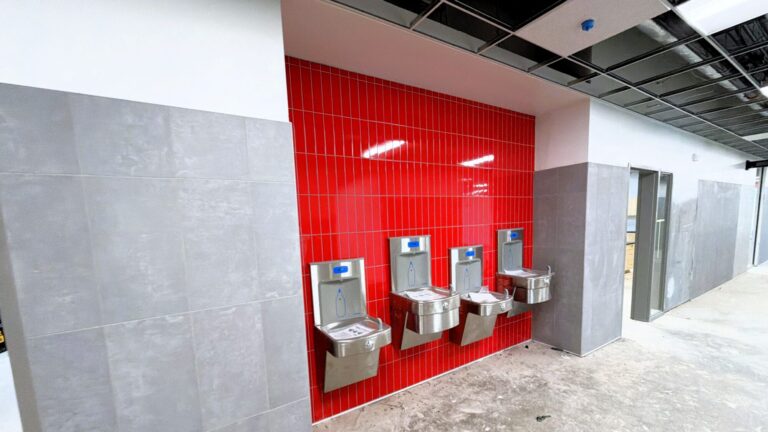

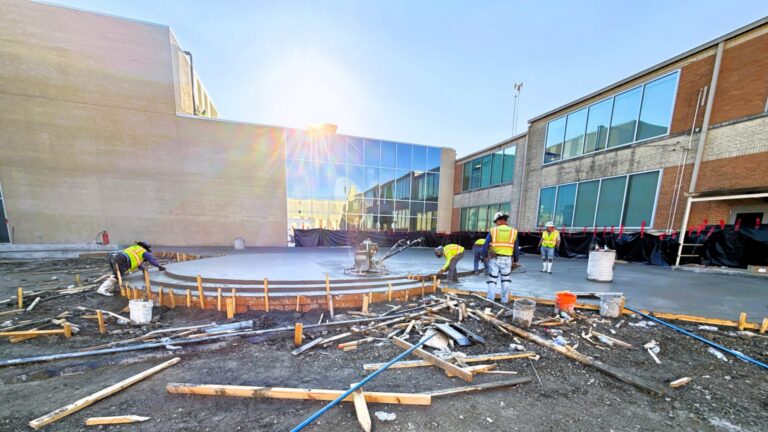

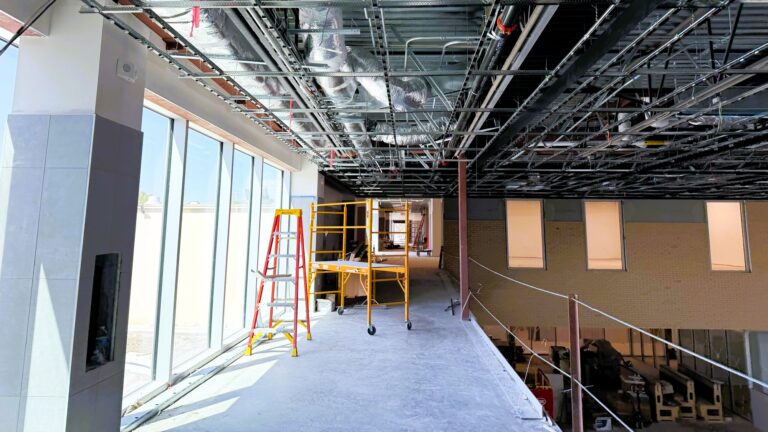

Interior renovations at Phase 5 have rapidly advanced, wall preparations and painting activities are currently underway. The Fine Arts Addition’s interior buildout has also begun drywall installation and painting activities across all three floors.

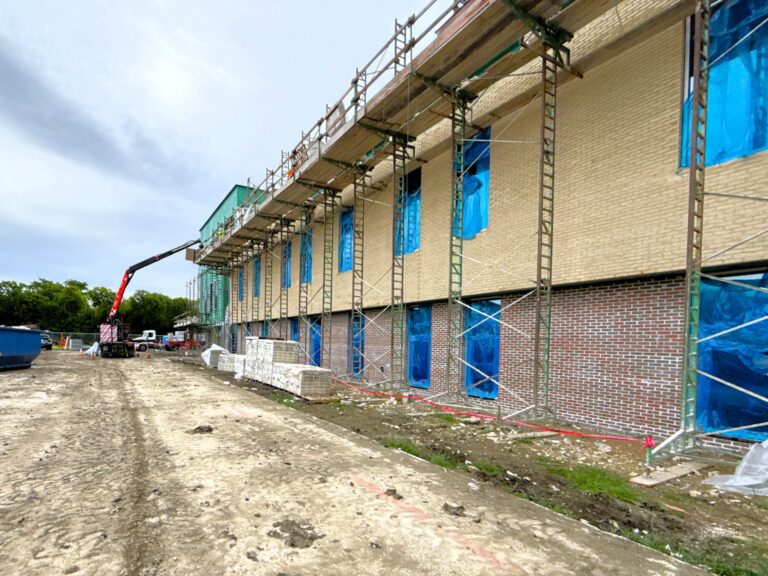

04/23/2026
Forest Oak Middle School:
Addition Update

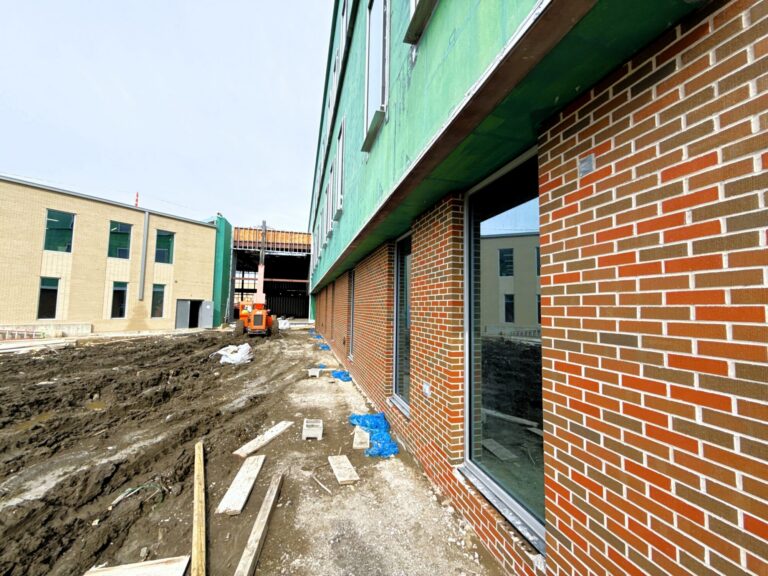

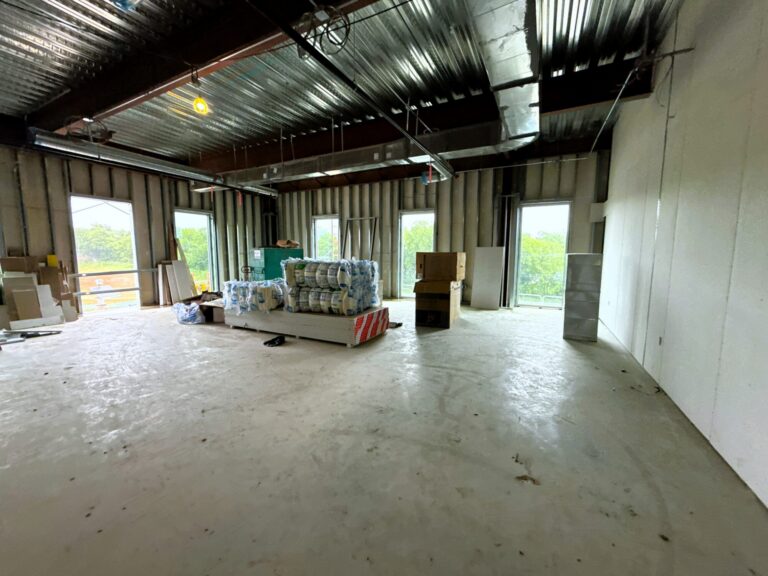

The 3-level Addition progress continues with strong momentum; exterior masonry, window framing, and glass installation are underway. Interior work has advanced to drywall installation.

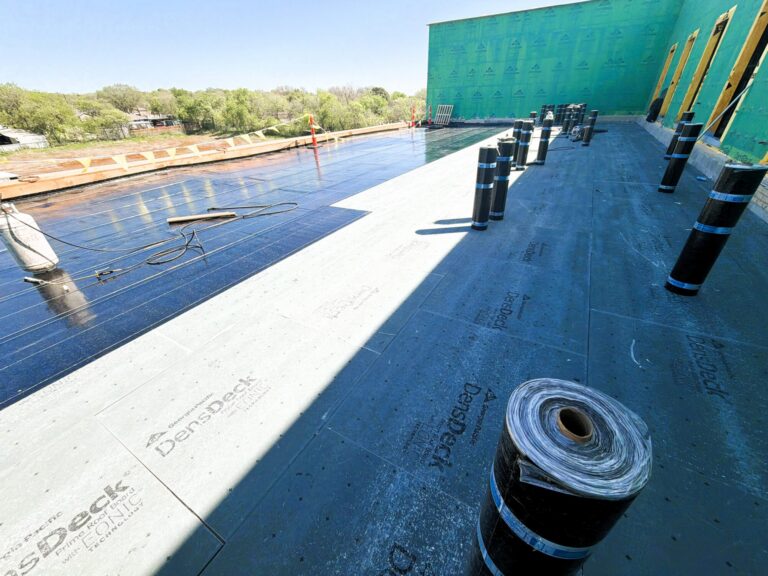

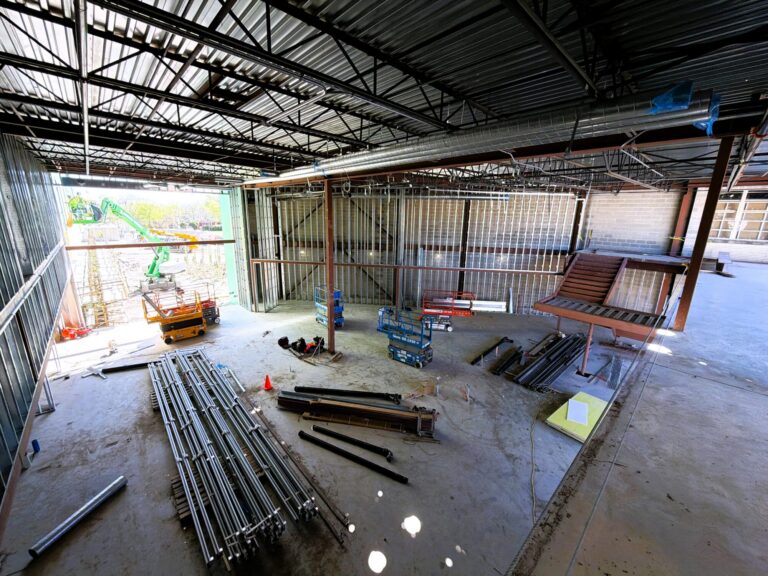

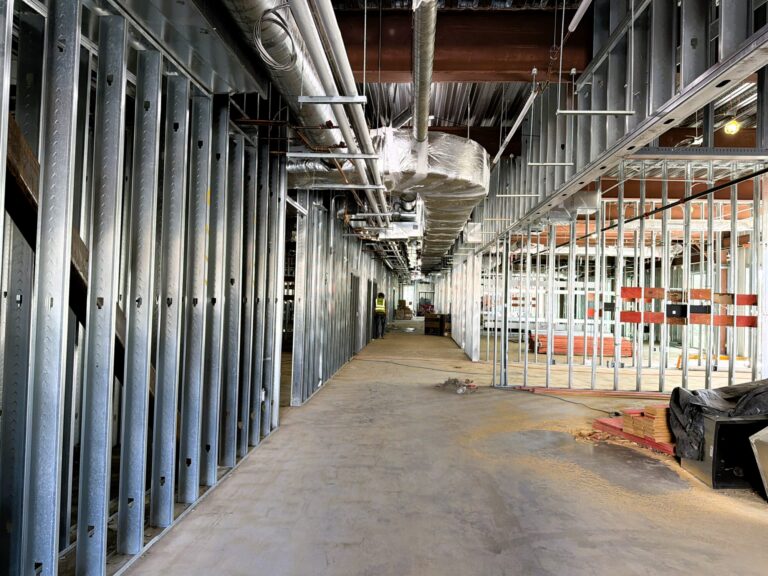

03/24/2026
Forest Oak Middle School:
Multiphase Advances

The 3-level Addition’s exterior masonry, window frame installation, and decking has begun.  Meanwhile, the interior 3 floors are in varying stages of framing and MEP rough-ins.  The renovations on the southern side of the building are nearly complete, pending ceiling closure.  Furniture installation and final move-in is scheduled to follow shortly thereafter.

02/24/2026
Forest Oak Middle School:
Addition Progress

Progress in the new building addition continues, the first & second floor framing is complete and in-wall MEP and overhead rough-in is underway. The third floor slab has been poured and exterior framing & sheathing are nearly complete.

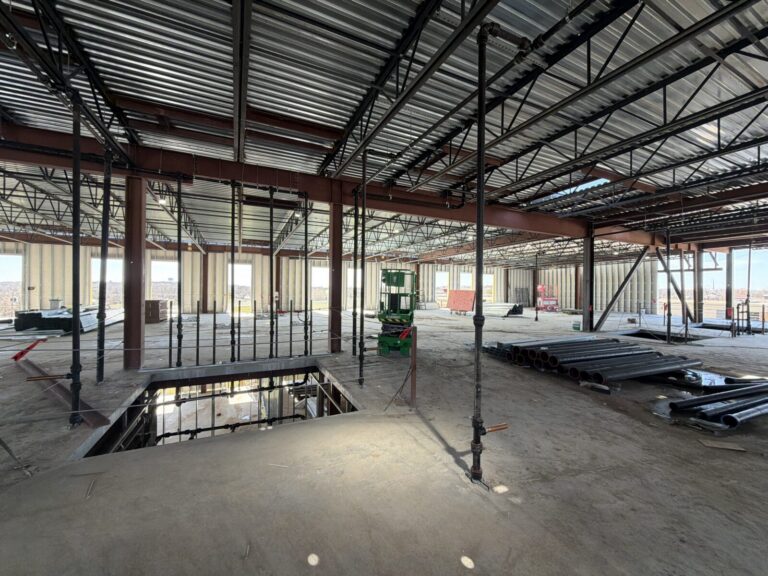

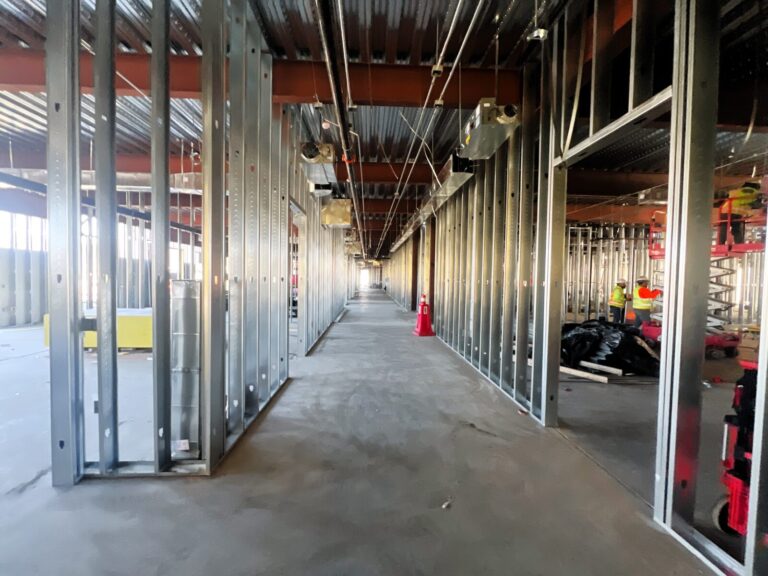

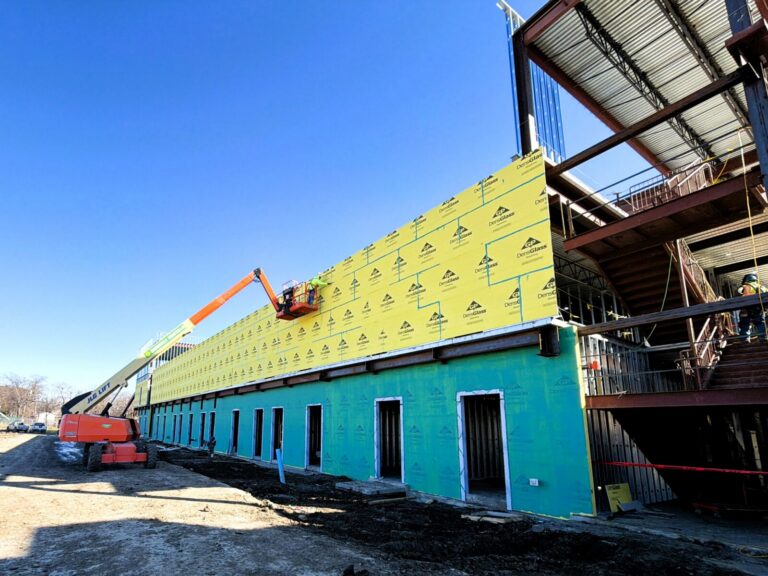

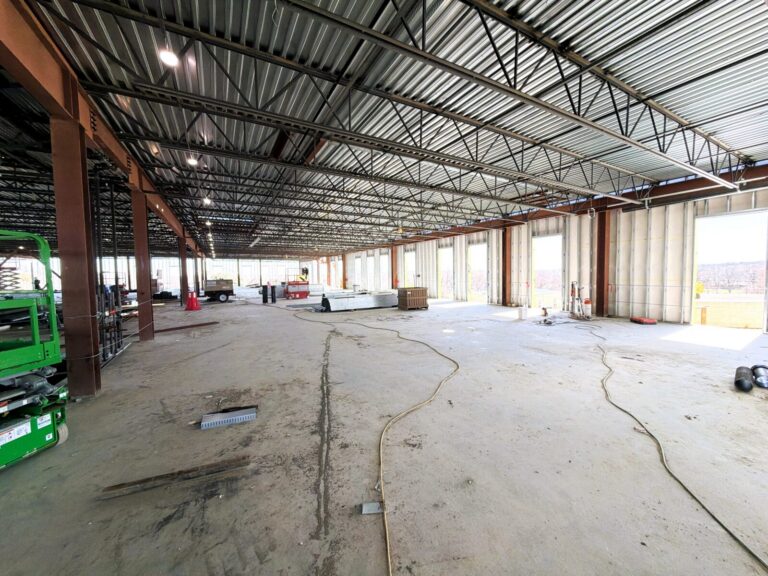

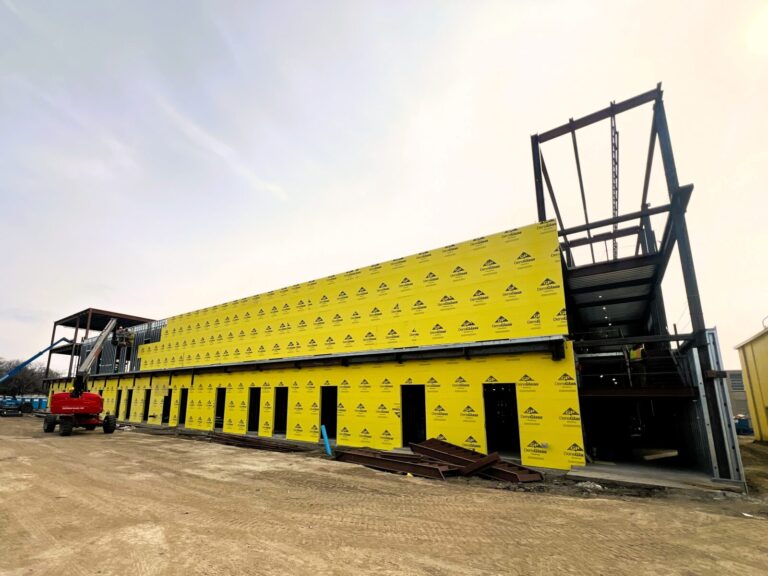

01/27/2026
Forest Oak Middle School:
Phase 4 Underway

Demolition is complete and overhead MEP installation is in progress. Interior framing activities have also begun and continue to advance. On the new building addition, the structure has been topped out, marking a major milestone. First-floor framing and exterior sheathing are underway. The second floor slab has been poured, and third-floor decking is currently in progress.

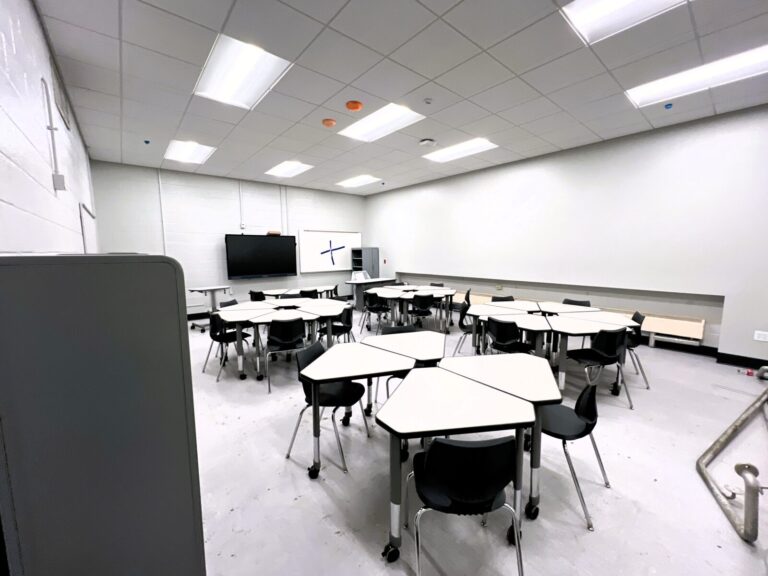

12/18/2025
Forest Oak Middle School:
Phase 3 Complete

Staff and students are scheduled to return to Phase 3 following winter break. Phase 4 work is set to begin at the start of winter break and construction of the addition remains ongoing, with steel erection continuing and second-floor decking underway.

11/26/2025
Forest Oak Middle School:
Phase 3 Nearing Completion

Phase 3 remains on schedule for early December completion, with final pain, flooring, and ceiling finishes underway. FF&E delivery and installation are set to begin soon. The new addition is also progressing well, with steel erection underway as construction moves forward.

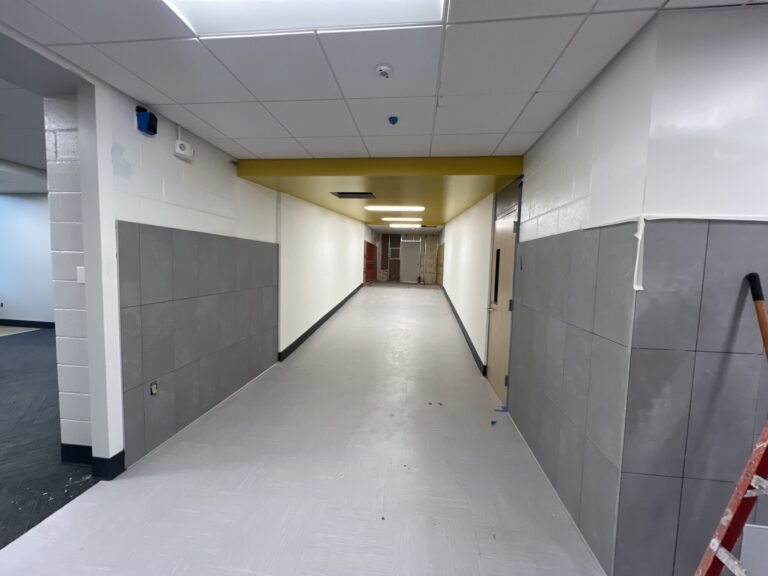

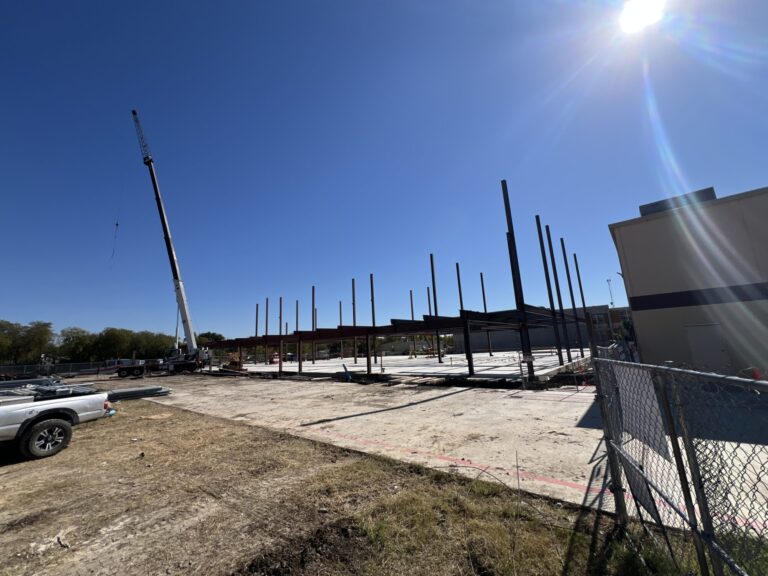

10/31/2025
Forest Oak Middle School:
Phase 3 Progress

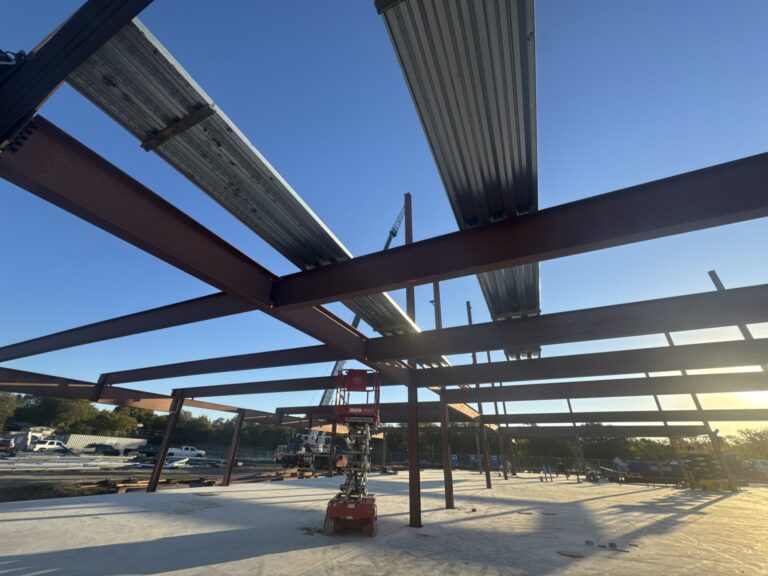

Overhead MEP systems & in-wall rough-ins are complete, and all new wall framing is finished.  Window installation & drywall are done and painting is expected to wrap up soon.  The ceiling grid is in place, lighting and HVAC ductwork are being routed. Meanwhile, the addition’s foundation has been poured and structural steel is being prepped for erection.

09/30/2025
Forest Oak Middle School:
Renovations Progressing Across Campus

The boys’ and girls’ locker rooms have passed final inspections. Classroom punch list items are being completed. Construction on the next phase is moving forward with framing in place, while site and foundation work are scheduled to wrap up by the end of the month.

08/22/2025
Forest Oak Middle School:

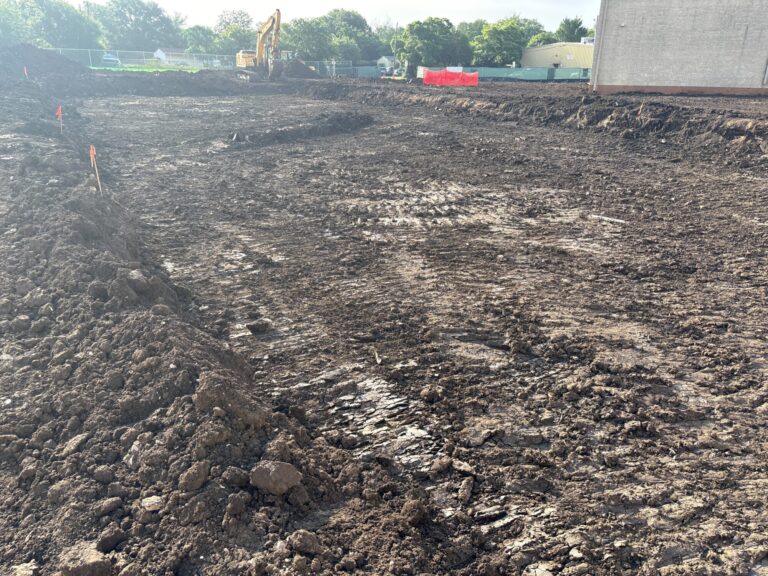

Phase 1 Classrooms Complete, Additional Work Progresses

Phase 1 classrooms were turned over to FWISD prior to the start of school. Locker room renovations are underway and expected to finish in August. Site work, including the bus lane and front entrance sidewalks, are complete. Foundation work for the new addition continues.
