Elementary School #2 Replacement & Consolidation at Maudrie Walton Site

This project is Under Construction

Key Information

Scope of Work:
This project includes a combination of new construction, building renovations, and site improvements.

Program Initiatives Addressed:

  • Elementary School Facility
  • Building Addition(s)
  • Classrooms and Science Labs
  • Media Center
  • Cafeteria/Cafetorium
  • Collaboration Space(s)
  • Interior Corridors
  • Secured Front-Entry Vestibule
  • Security and Life Safety Upgrades
  • MEP (Building Utilities)
  • Accessibility and Site Improvements
  • Furniture, Fixtures and Equipment
  • Technology and Digital Upgrades
  • Removal of Portable Building(s)
Design Process
Construction Process
5816 Rickenbacker Pl, Fort Worth, TX 76112, USA
Budget
$58,738,659
New Construction
53,900 SF
Renovations
37,507 SF
Construction Start
October 20, 2025
Anticipated Opening
August 2027
Anticipated Construction End
Q1 2028

Project Team

Headshot of Cale Wilkinson.
Cale Wilkinson
Owner’s Representative
Pete Valdez
Senior Construction Manager
Contractor
Sedalco
KAI Architect logo.
Architect
KAI

Project Updates

Subscribe to emails with updates for this project. You’ll receive a verification email after your first project sign-up.

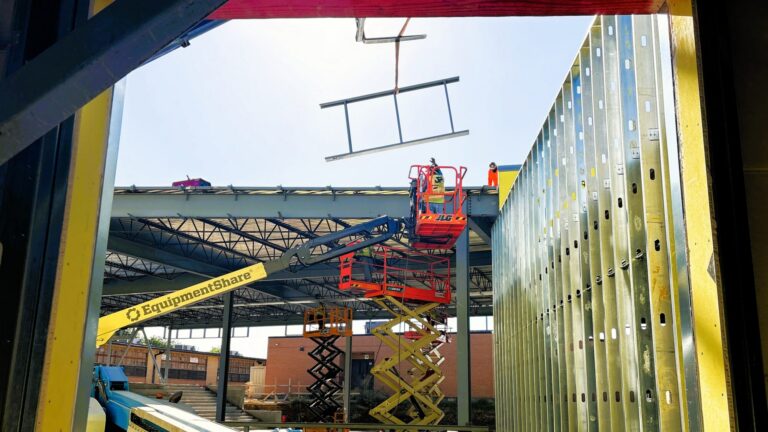

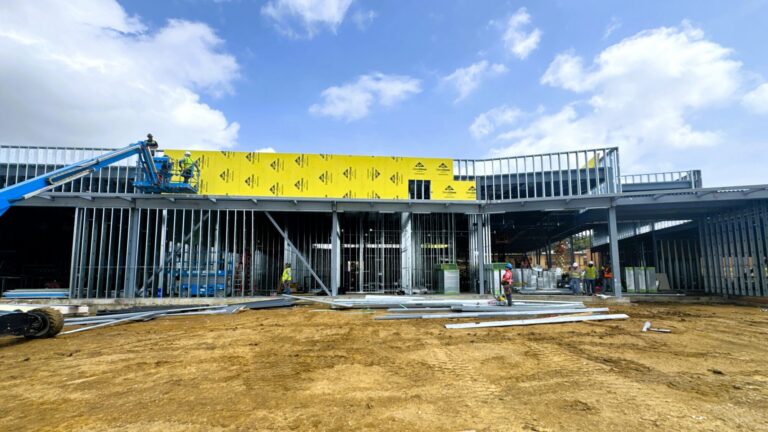

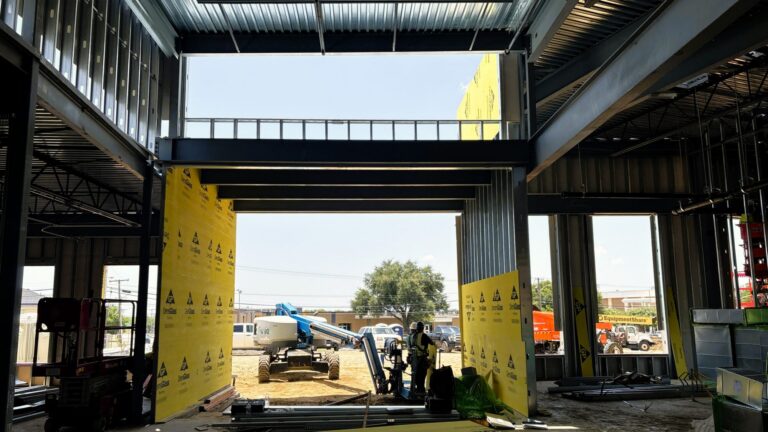

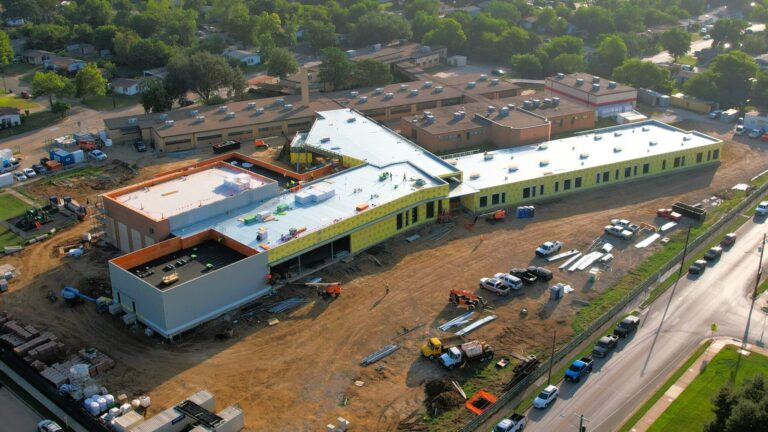

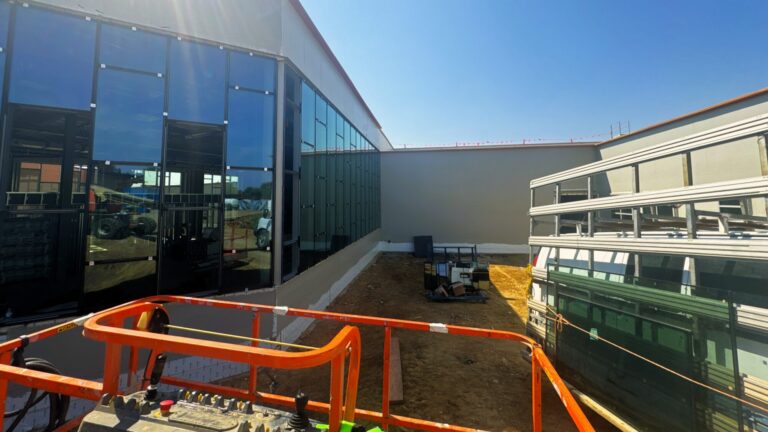

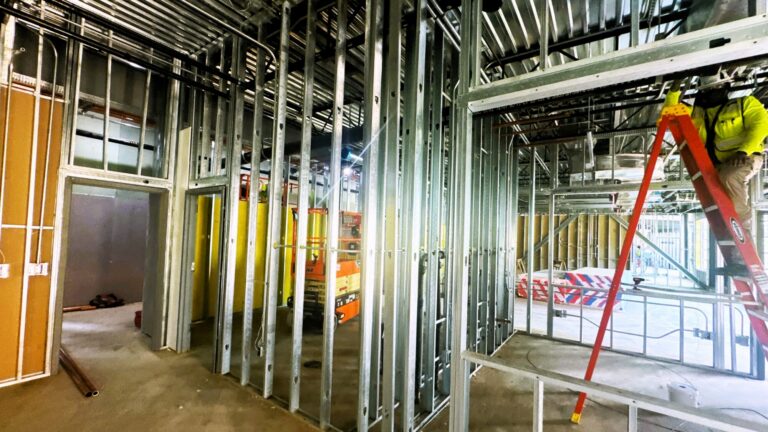

07/22/2026
Maudrie Walton Elementary School:
Summer Work Continues

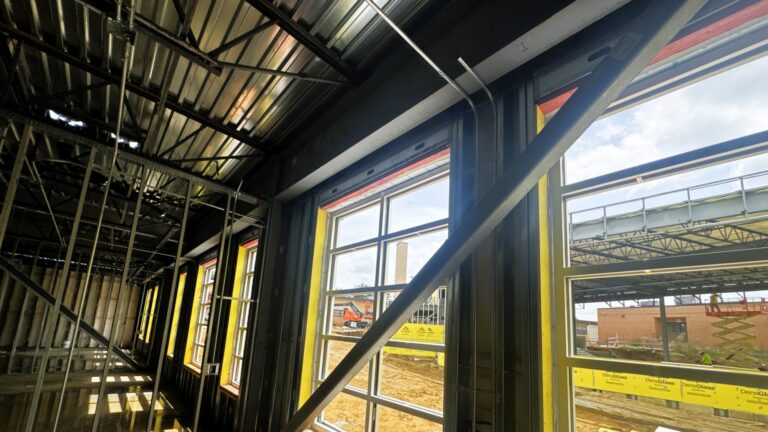

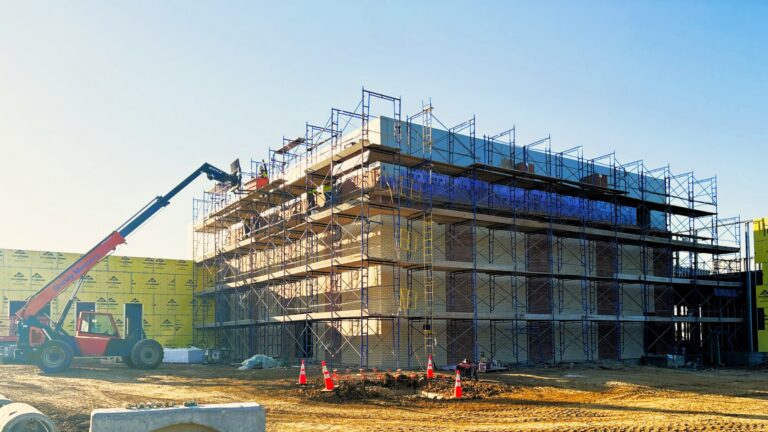

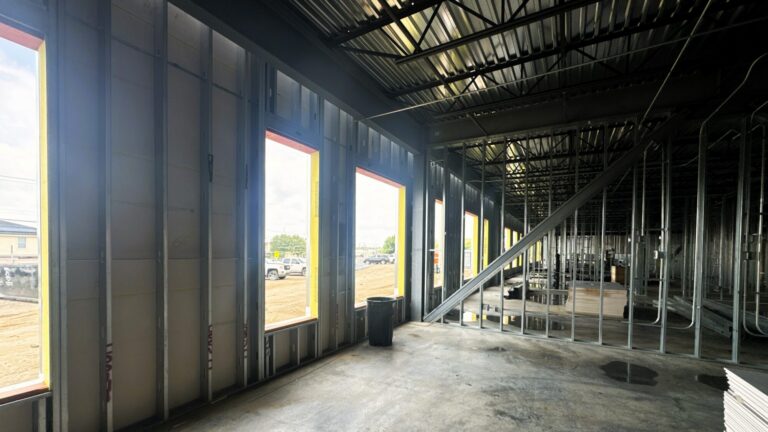

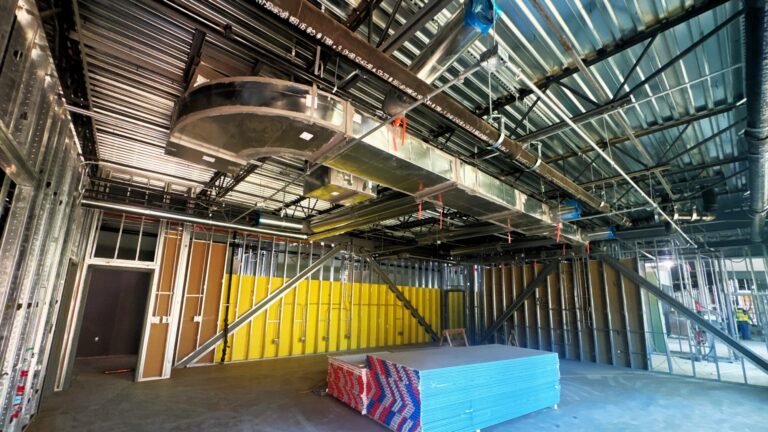

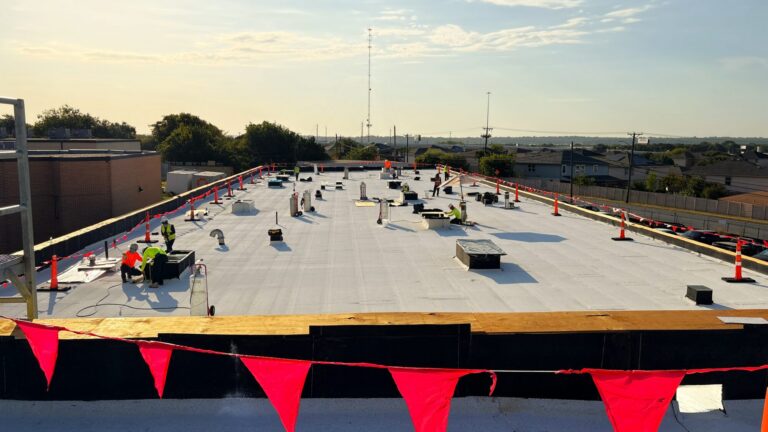

Phase 1, the Campus Addition, continues with exterior sheathing and roof installation. Building enclosure activities are underway as well. This includes installation of the air/water barrier, window systems, and exterior cladding.

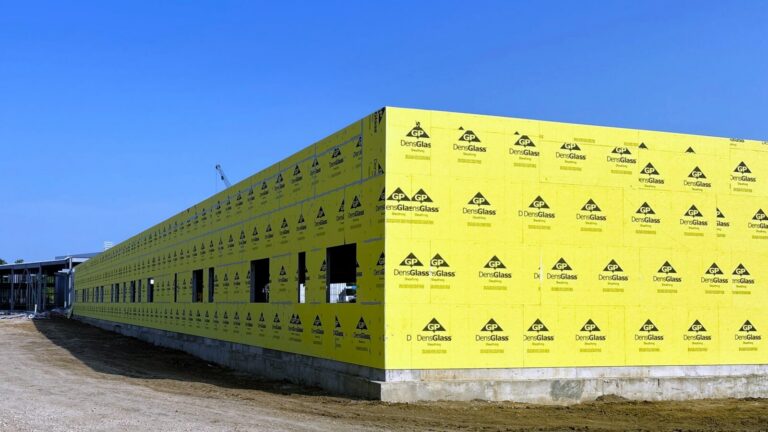

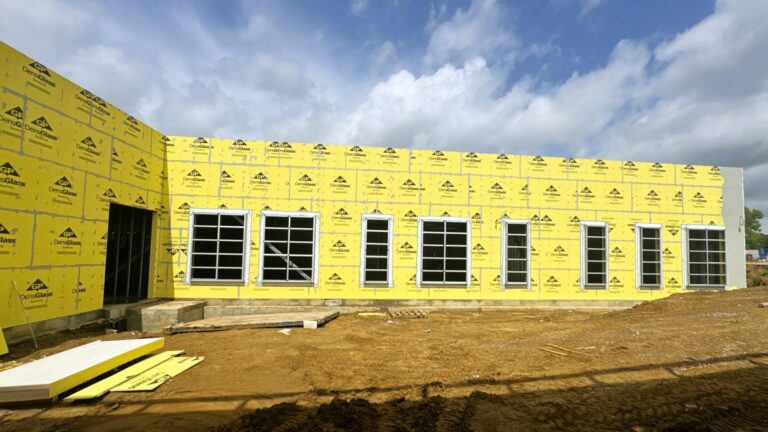

06/22/2026
Maudrie Walton Elementary School:
Summer Progress

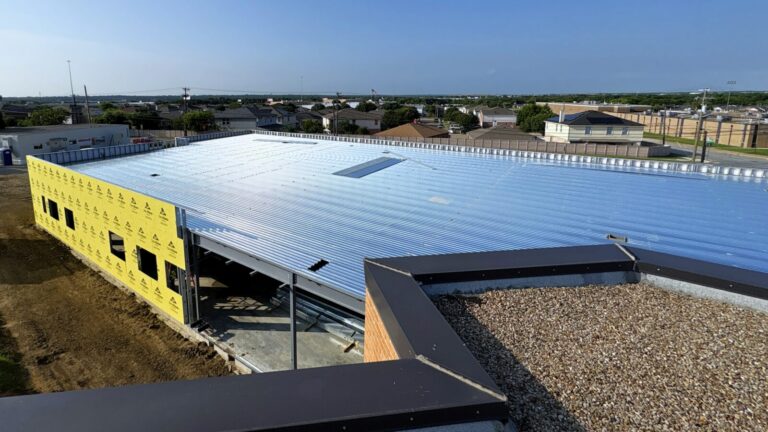

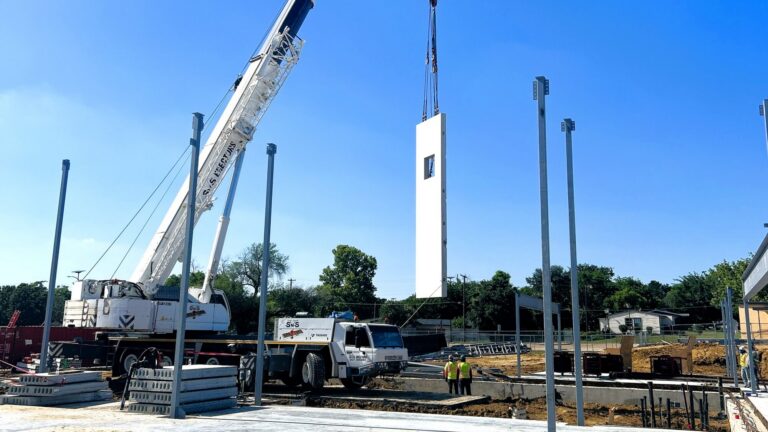

The Campus Addition’s structural steel has been erected, promptly followed by the metal roof deck installation. Sheathing installation is also in progress in preparation for exterior finishing.

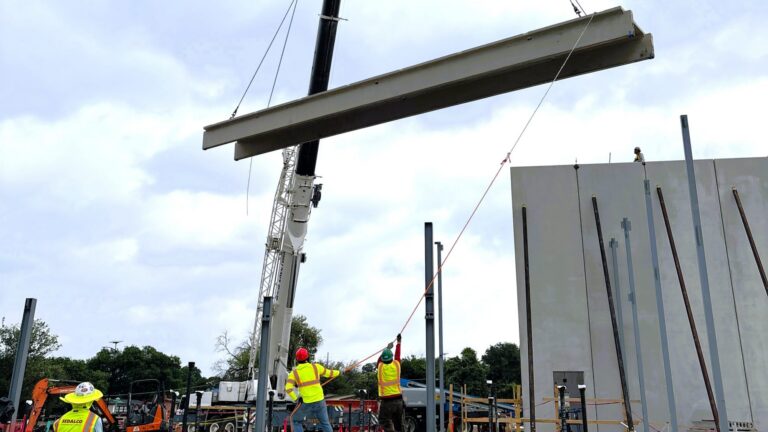

05/20/2026
Maudrie Walton Elementary School:

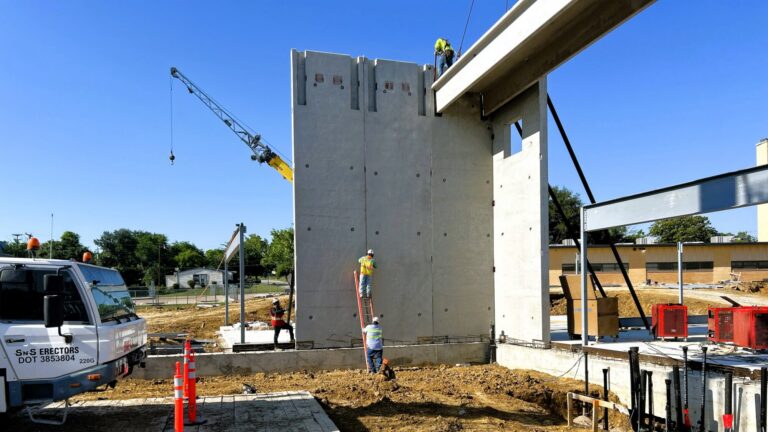

Storm Shelter Formation

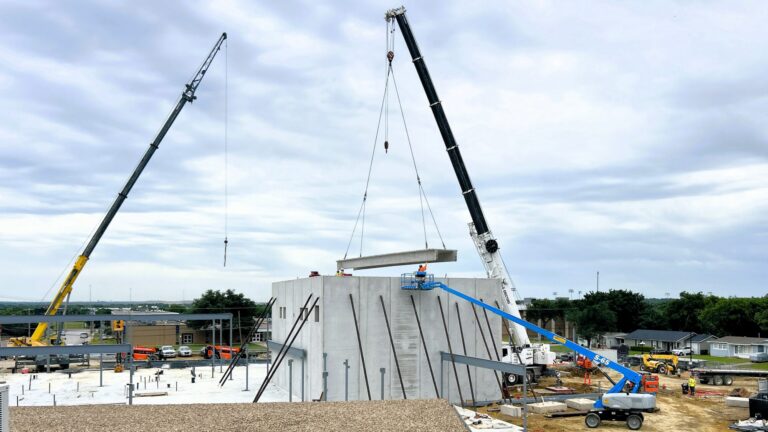

Structural precast panels forming the campus storm shelter were hoisted, erected and installed at the Gym Addition.

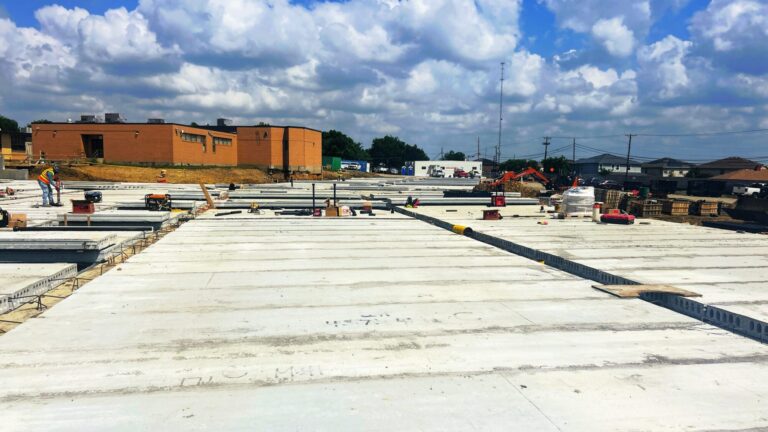

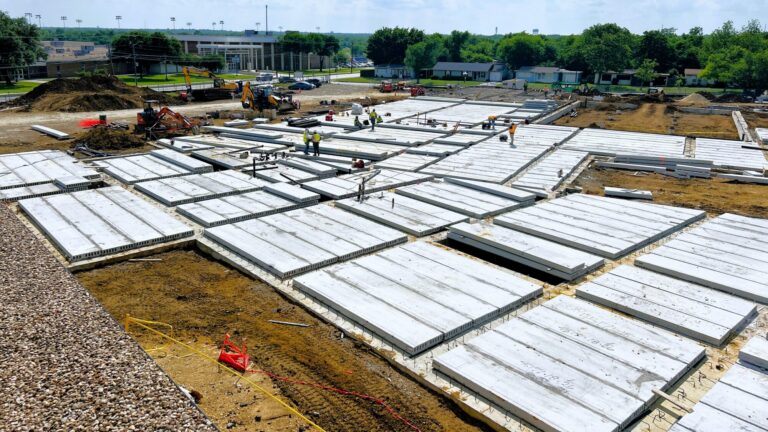

04/29/2026
Maudrie Walton Elementary School:
Structural Progress

Site work continues, hollow core planks are set while underslab mechanical, electrical and plumbing work advances at the additions.

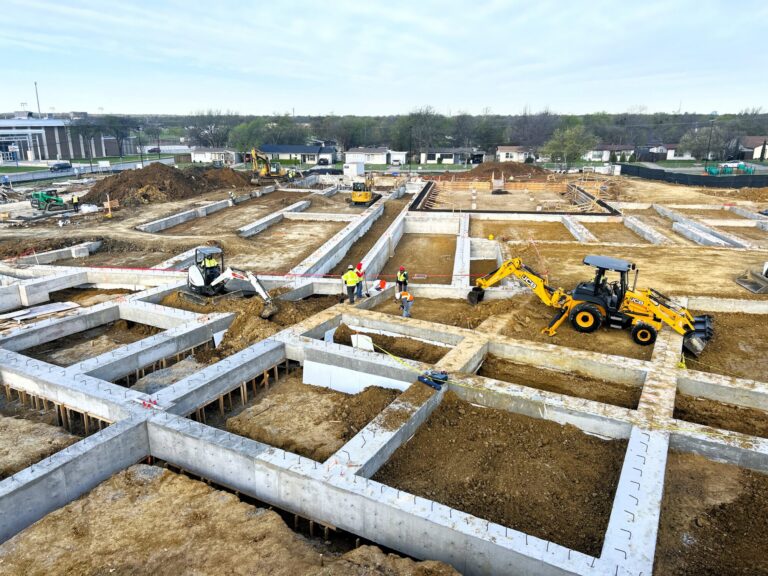

03/24/2026
Maudrie Walton Elementary School:

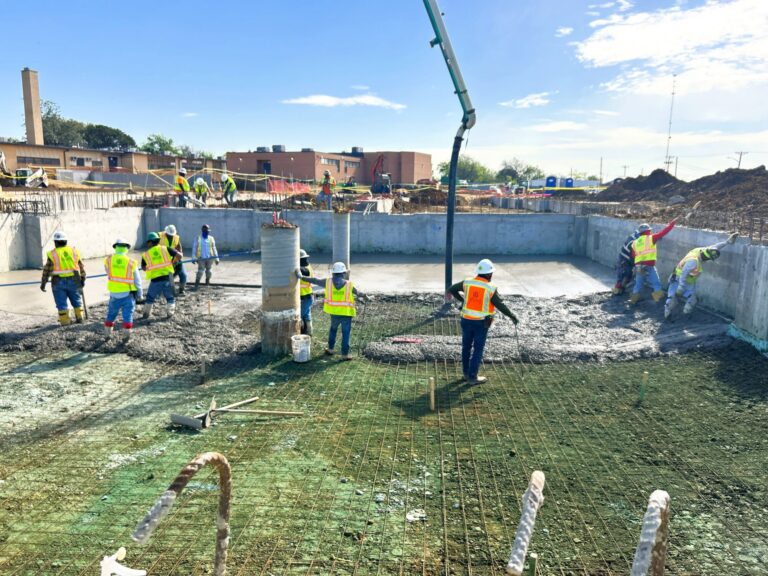

Grade Beams at the Addition

The project continues to make progress on the Addition’s foundation elements.  Grade beams have been successfully poured at the Cafeteria/Gym wing and the Admin/Media site.  Work is actively underway on the Kinder/PreK wing grade beams, with completion scheduled by the end of the month. Backfilling operations is scheduled to support site stabilization.

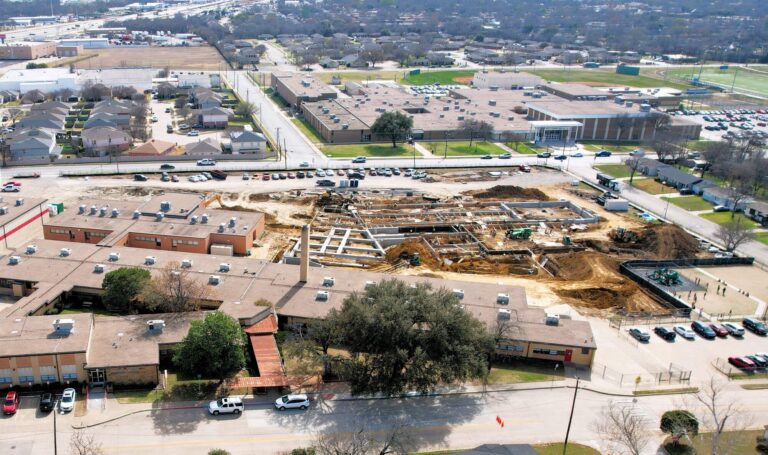

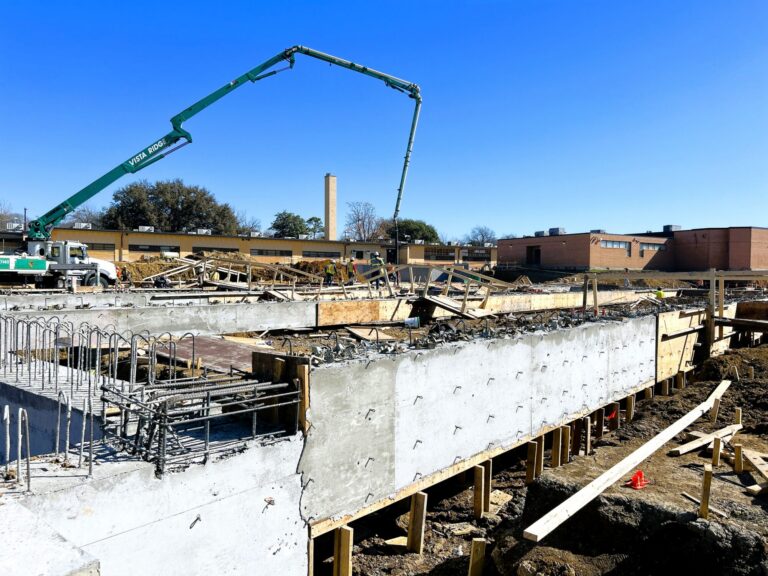

02/25/2026
Maudrie Walton Elementary School:
Site Work for Building Addition

Piers have been poured for the new classroom addition and grade beams in the new kitchen area are in place. Coordination with the electric utility is moving forward and under slab plumbing will be starting soon in preparation for the concrete slab pour.

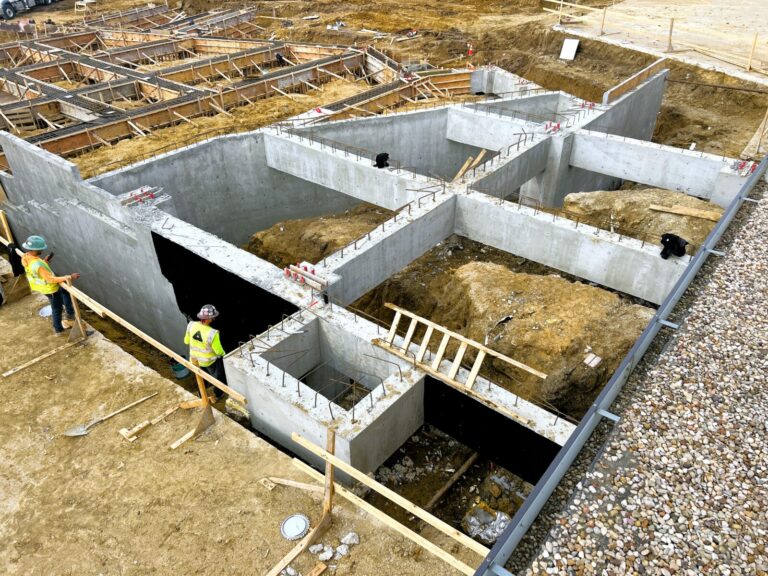

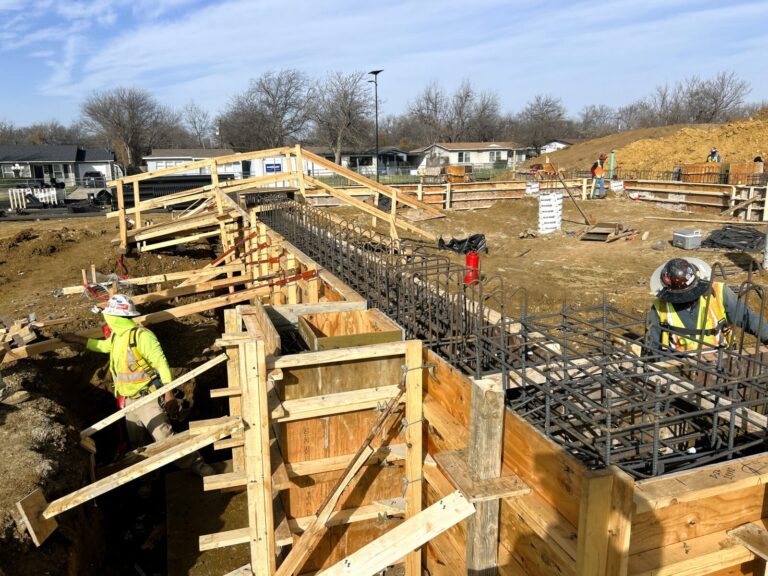

01/27/2026
Maudrie Walton Elementary School:
Foundation

The new storm drainage line installation is compete and work has begun on the piers for the new building and site grading operations. Next steps are forming and setting the grade beams to connect and support the piers as part of the foundation system.

12/18/2025
Maudrie Walton Elementary School:
Under Construction

Maudrie Walton Elementary is now under construction and Sedalco Construction Services has begun by demolishing the existing portables and dirt work cuts & fills. Storm drains are being installed in the new classroom addition area, layout and pier drilling to follow.

10/31/2025
Maudrie Walton Elementary School:
Groundbreaking

FWISD, PROCEDEO, and awarded General Contractor, Sedalco Construction, broke ground marking the beginning of this project which includes a major building addition, new classrooms, a media center, fine arts rooms, a storm shelter, and a playground.

08/30/2024
Maudrie Walton Elementary School:
Exterior Conceptual Renderings

The new Maudrie Walton Elementary School is on schedule to begin construction during Q1 of 2025. The project will include the construction of new classrooms, science & collaboration areas, a new media center & performance arts area, new cafeteria & kitchen, and new administration spaces. Pictured are conceptual renderings of the new front entry.
