Riverside Middle School

This project is Under Construction

Key Information

Scope of Work:
This project includes a combination of new construction, building renovations, and site improvements.

Key Improvements:

  • New building additions – fine arts.
  • Removal of portables and minor exterior/site improvements.

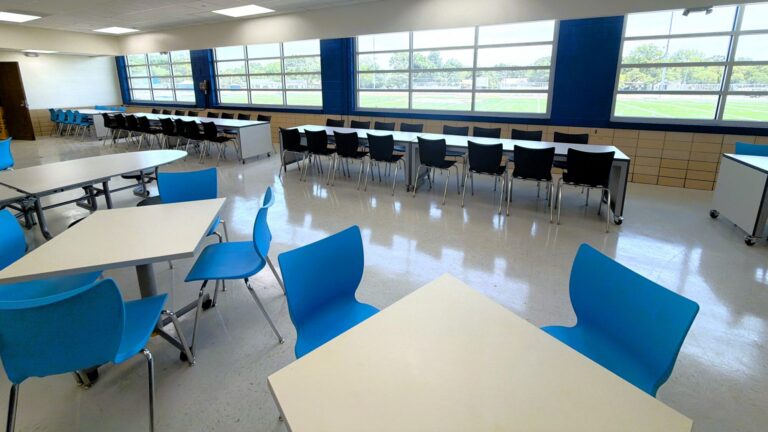

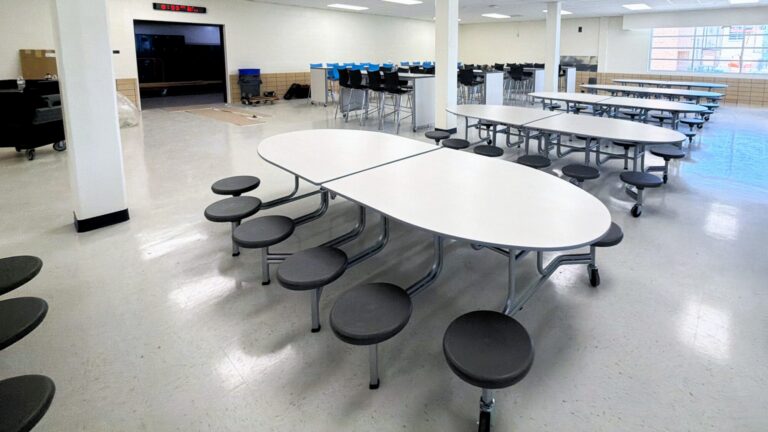

  • Interior renovations – front entry vestibule, corridors, media center, cafeteria, and interior finishes.
Design Process
Construction Process
1600 Bolton St, Fort Worth, TX 76111, USA
Budget
$48,339,877
New Construction
14,500 SF
Renovations
126,716 SF
Construction Start
February 3, 2025
Anticipated Opening
Continued Use
Anticipated Construction End
Q2 2027

Project Team

Cameron Whitaker
Owner’s Representative
Pete Valdez
Senior Construction Manager
Contractor
Cadence McShane | Morales JV
Parkhill logo.
Architect
Parkhill

Project Updates

Subscribe to emails with updates for this project. You’ll receive a verification email after your first project sign-up.

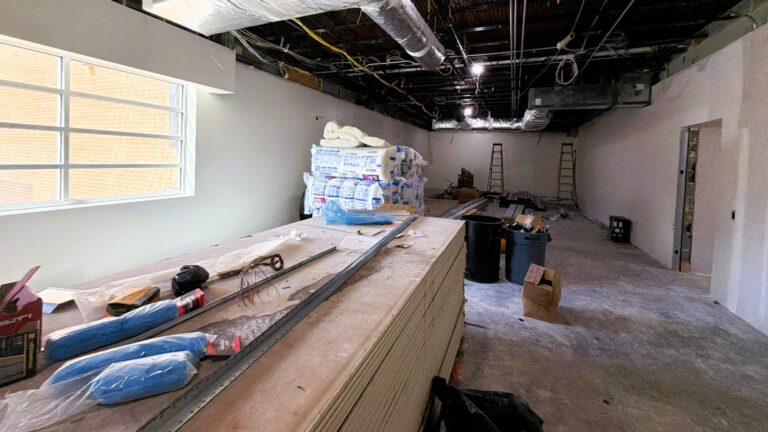

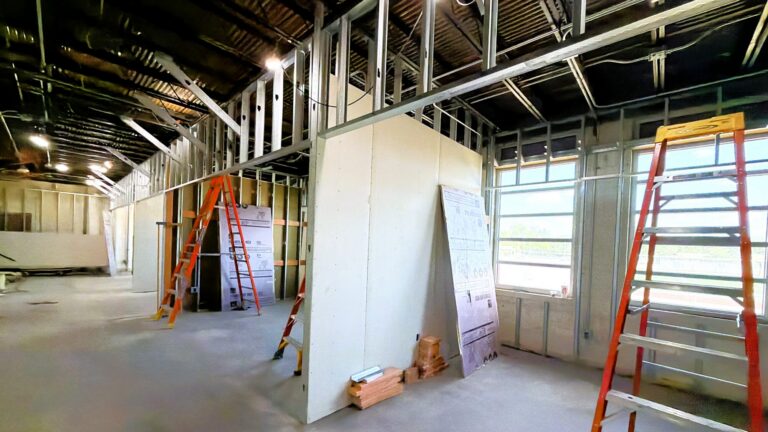

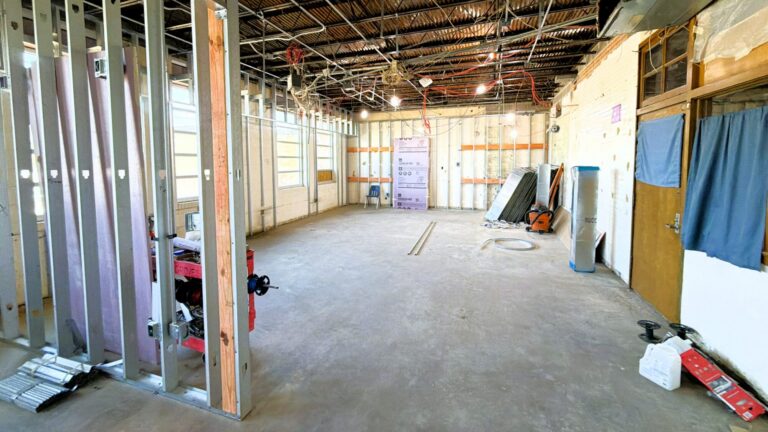

04/24/2026
Riverside Middle School:
Phase 5 Begins

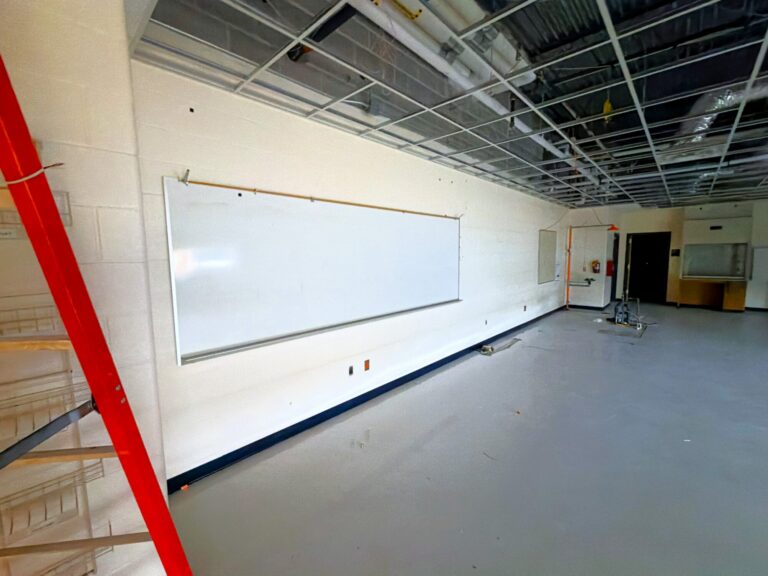

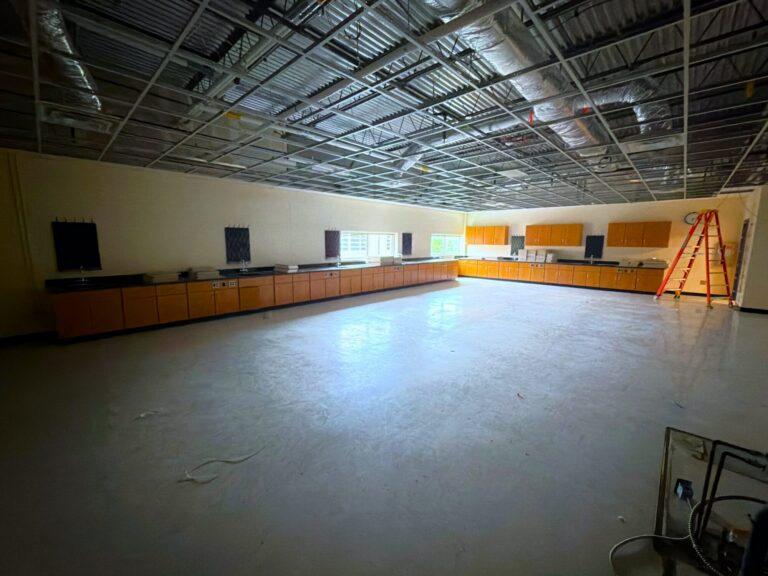

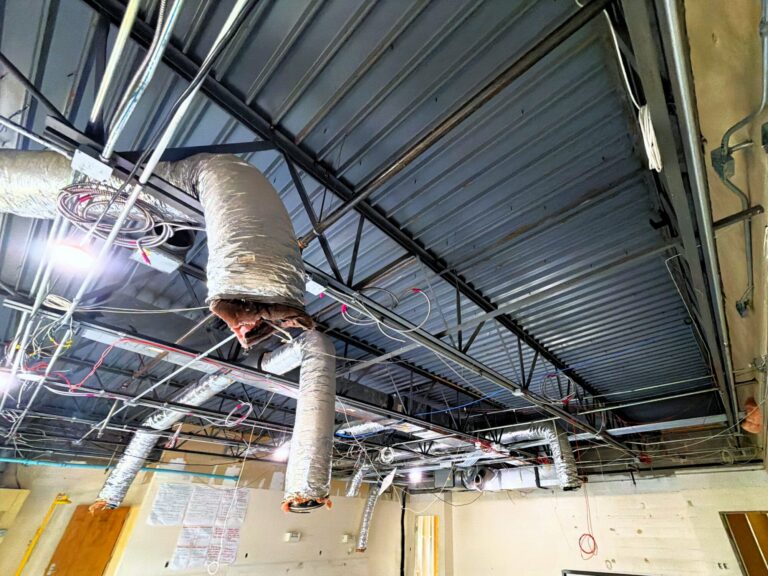

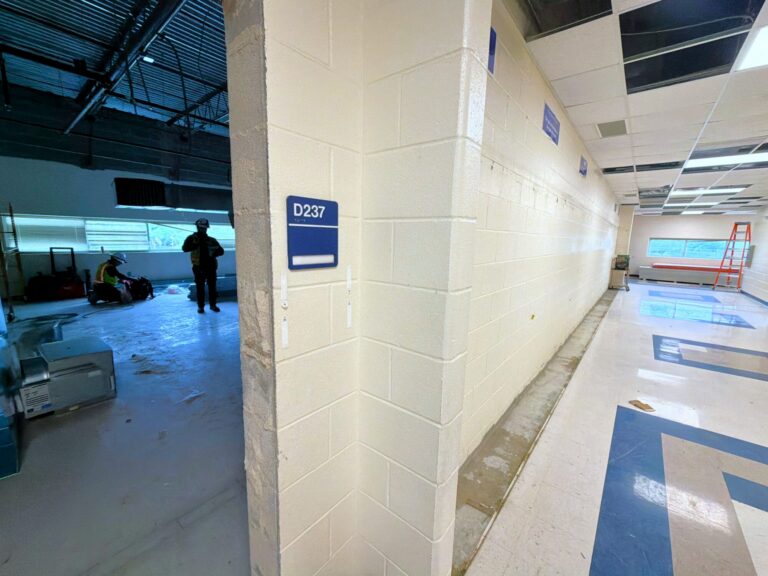

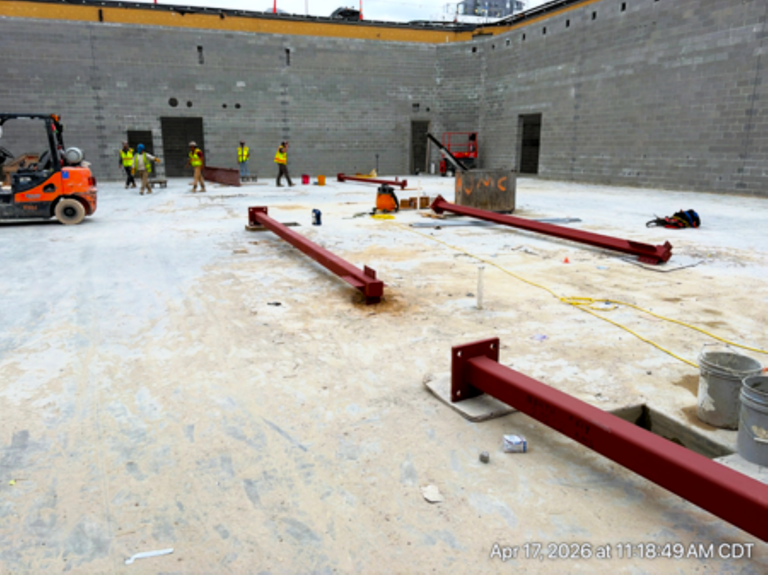

Demolition is complete and MEP installation is in progress at Phase 5. Overhead rough-in activities are also underway and continue to advance. Auditorium renovations continue with the HVAC ductwork installation nearing completion. At the new Fine Arts Building, structural steel has been delivered and staged for placement.

03/25/2026
Riverside Middle School:
Phase 4 Interior Renovations

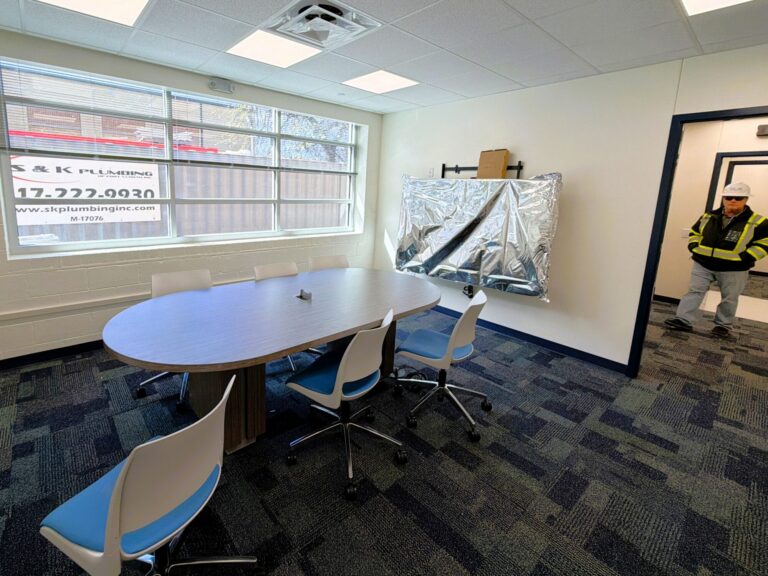

Phase 4 interior renovations of first floor admin office spaces have been completed, including finishes and furniture installation. All areas are preparing for final closeout activities, with turnover anticipated by the end of the month.  The auditorium’s false floor has been positioned and the new fire suppression system is being installed. Concrete masonry walls are taking shape at the new Fine Arts Addition.

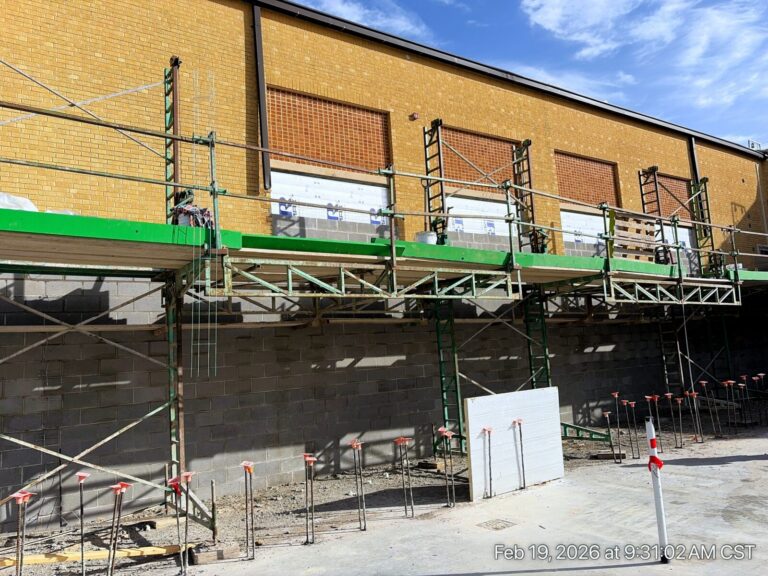

02/25/2026
Riverside Middle School:
Phase 3 Completion & Phase 4 Steady Progression

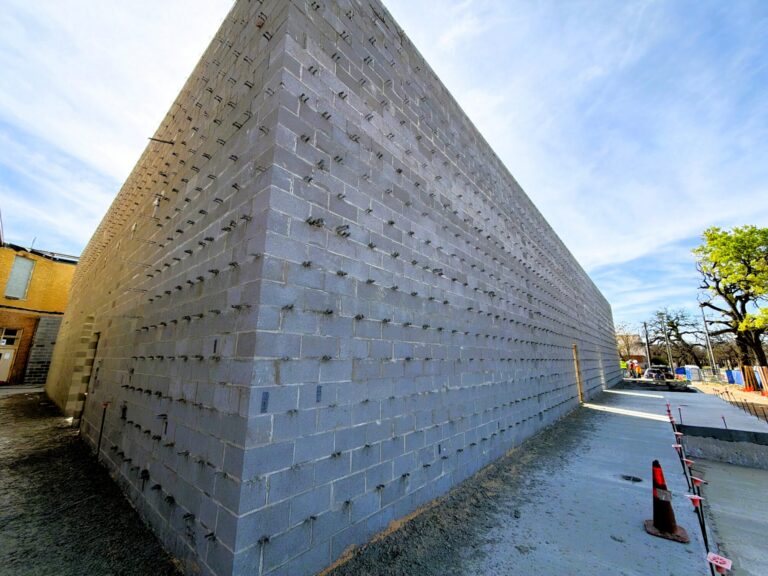

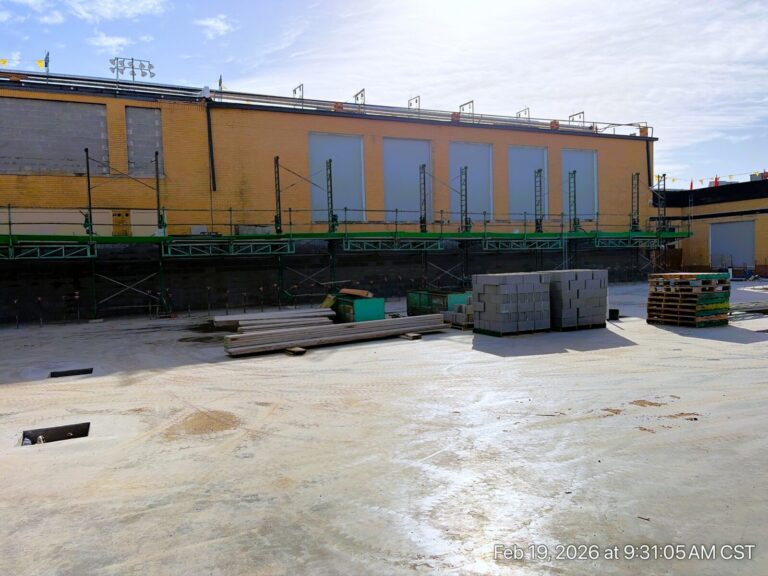

Phase 3 has been completed and successfully turned over to staff and students. Phase 4 drywall installation is complete, while Phase 4.5 demolition is done and overhead MEP installation underway. The building addition continues to advance, allowing exterior CMU wall installation to begin.

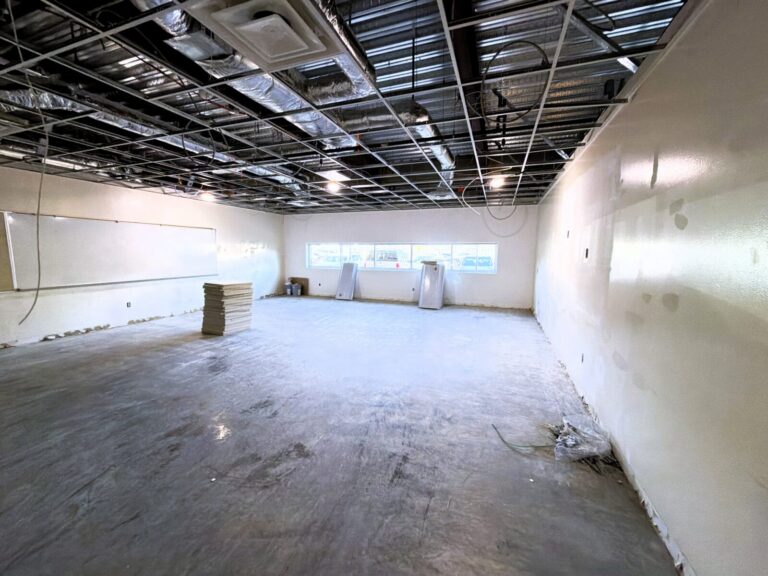

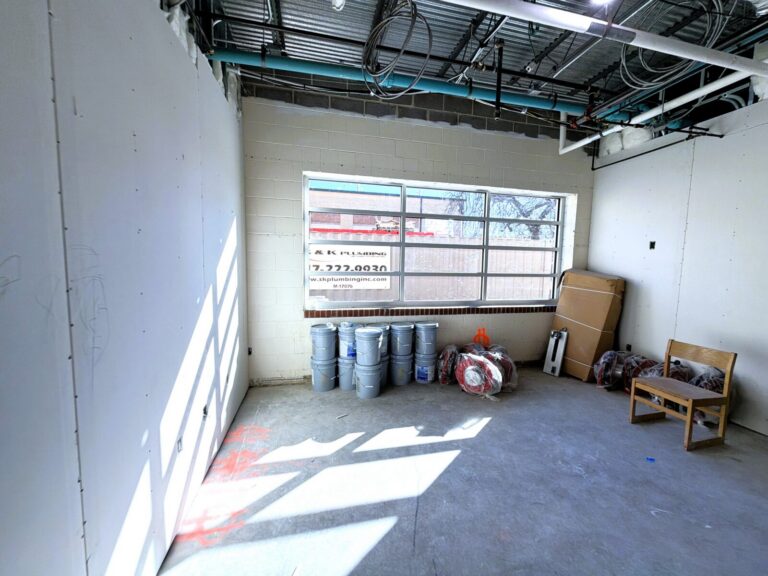

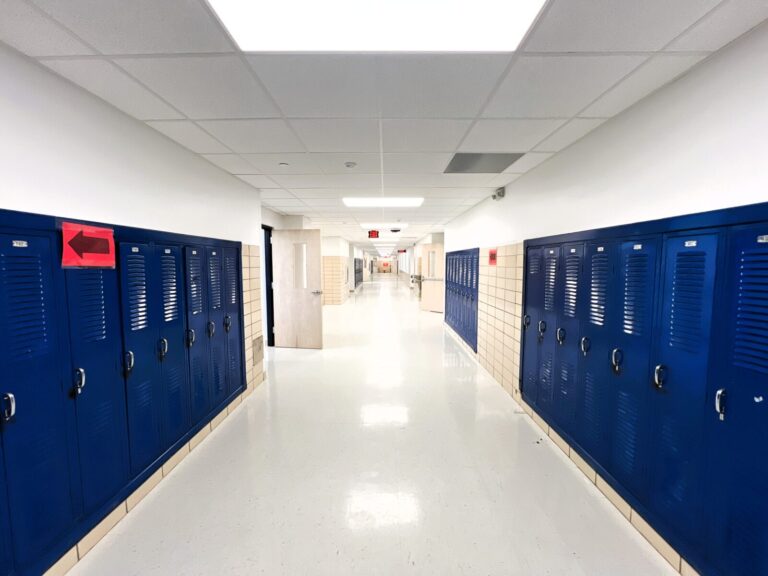

01/27/2026
Riverside Middle School:
Phase 3 & 4 Update

Phase 3 is nearing completion, with turnover anticipated by the end of the month. Phase 4 is currently underway, with framing and in-wall MEP installations complete. Drywall installation is in progress throughout Phase 4 areas. Overhead MEP installation is also underway and continuing to advance. The addition slab has been poured, and associated civil site work is currently in progress.

12/18/2025
Riverside Middle School:
Phase 3 Progress & Phase 4 Begins

Phase 3 framing and drywall are complete and overhead MEP rough-in activities continue. Phase 4 is underway, with demolition complete and framing and in-wall MEP installation progressing. Foundation work for the addition has advanced, with grade beams poured and slab preparation currently underway.

11/26/2025
Riverside Middle School:
Phase 3 Construction Advancing

Phase 3 construction is moving forward with framing, drywall, HVAC, and electrical work underway. The new building addition is also advancing, with foundation work moving forward and and slab placement scheduled next.

10/31/2025
Riverside Middle School:
Phase 3 Renovations

Phases 1B and 2B have been completed and turned over to staff and students. Phase 3, featuring demolition, overhead MEP installation, and exterior window removal in preparation for new window installation are in progress. In the addition, pier drilling is nearly complete.

09/30/2025
Riverside Middle School:
Phase 2B Nearing Completion

Phase 2B classrooms are close to completion with flooring, inspections, and casework installation underway. Furniture installation is scheduled by late September. The JCC and wight room are progressing, with equipment installation set for end of September. Foundation preparations for the addition are also moving forward.

08/26/2025
Riverside Middle School:
Phase 1 Complete, Phase 2 Underway

Phase 1 classrooms were completed and ready for the first day of school. Work continues in Phase 2, with completion expected in September, while roofing and HVAC installations progress across the campus.

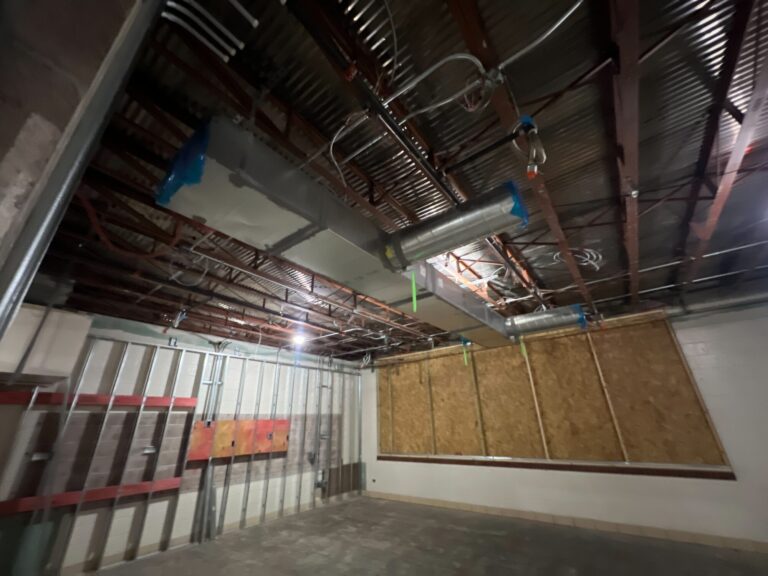

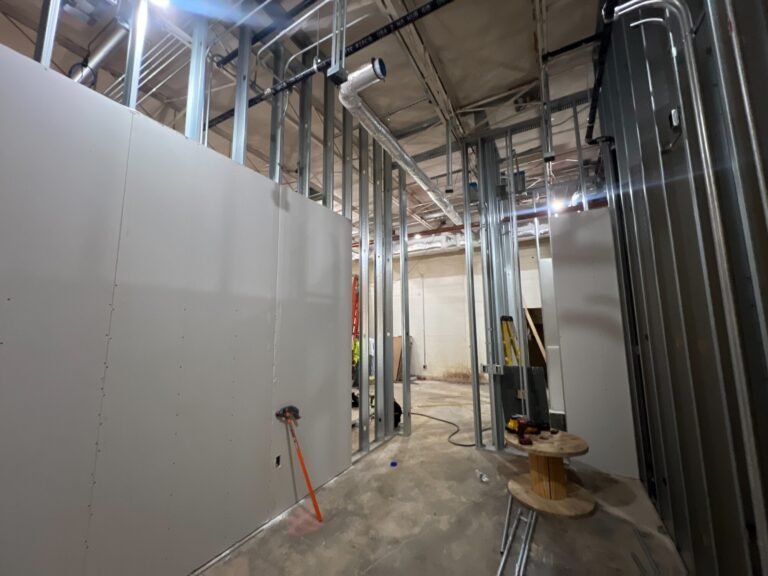

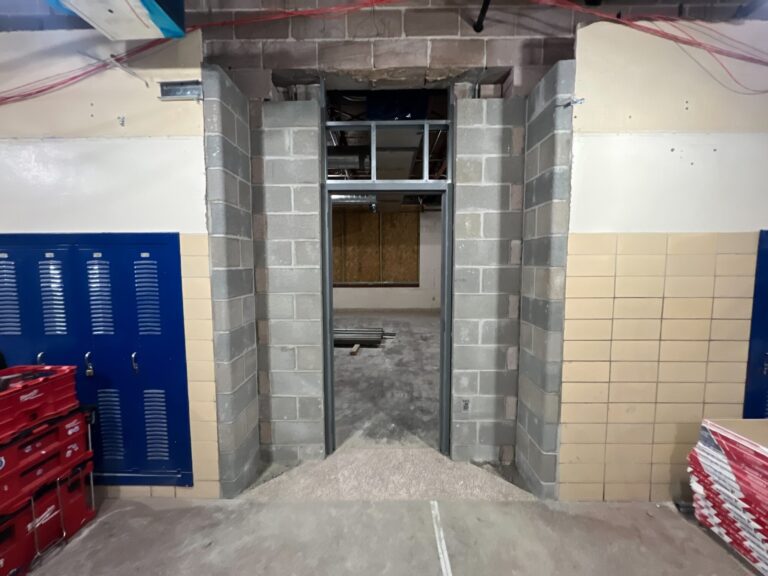

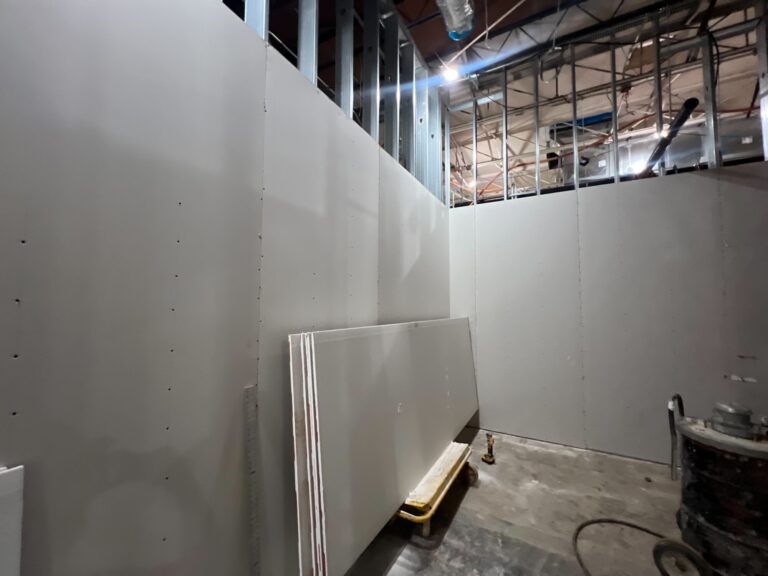

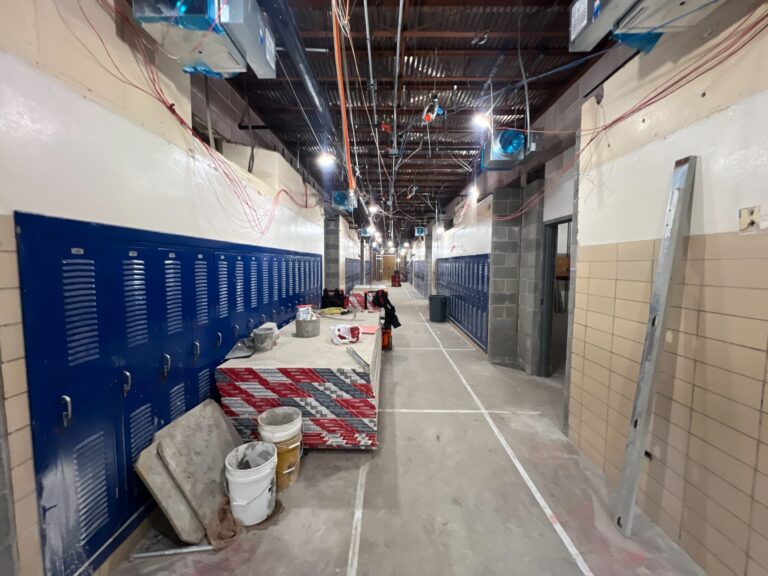

07/29/2025
Riverside Middle School:
Phase 1 Classrooms Near Completion

Phase 1 spaces are nearing completion with systems and finishes installed. In Phase 2, framing and drywall are underway. On-site utility work continues with power restoration expected by late July.
